On Tuesday afternoon, outside the certification chamber, the product engineer stares at a printout. The program manager stares at the phone. The product has failed its first round of EMC testing, and the team realizes too late that the pre-compliance groundwork behind any clean product certification should have started months earlier. Everyone starts doing mental math on what it will cost to start again from nothing.

It happens more often than the industry admits. Industry sources such as In Compliance Magazine and Keysight Technologies have repeatedly noted that first-pass EMC success drops sharply when teams skip pre-compliance work (Pre-compliance value; Keysight pre-compliance). The same pattern shows up across safety, environmental, reliability, and broader product compliance testing: a 30-day certification window can become 90 days, and a $30,000 program can become a much larger unplanned expense.

The lesson is simple: certification success is rarely decided inside the formal lab. It is decided earlier, when teams make compliance visible in the design workflow, measure risk before the final booking, and correct issues while fixes are still inexpensive.

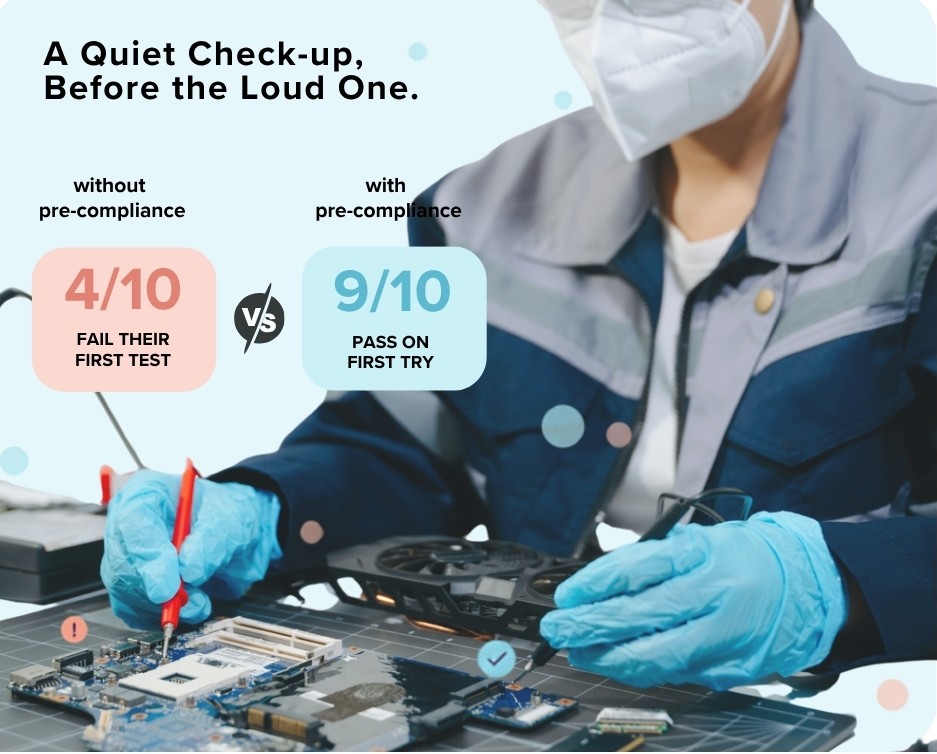

Fig. 1. A quiet check-up before the loud one - pre-compliance hears what the certification chamber will hear.

Is This You?

Pre-compliance is filed under "engineering problems," but the people it really protects are scattered across the org chart.

  • Product Managers - every failed cycle can slip on a launch date and put committed quarterly revenue at risk.
  • Hardware Engineers - decisions made quietly at the schematic level to decide whether the product passes months later.
  • Startups - one unexpected re-test can devour the runway you need to reach the next milestone.
  • OEMs - you are not certifying for one market but ten, each with its own path to failure.

The Cost of Pre-Certification Delays

Certification of economics is more predictable than most teams assume. Depending on product complexity, accredited EMC labs place CE/FCC certification between $1,000 and $20,000, with chamber time running $1,500 to $2,500 a day. In high-reliability markets - automotive, medical, defense - that rises to between $13,600 and $34,000 per cycle, and most teams carry a further 10% to 30% buffer for design changes after a failure (EMC cost guide). Safety testing to IEC 62368 and IEC 60601 sits in a similar range, as does environmental testing to MIL-STD-810 and IEC 60068 (IEC 60601 safety).

Then comes the second layer of cost, which no quote carries. A failed cycle means waiting four to six weeks for a chamber slot. It means paying for a design review, spinning up a new board, and building fresh samples. By the time the team is back in front of the chamber, 90 days have gone by. This is why early compliance testing services matter: they turn certification risk into a managed engineering queue rather than a launch-threatening surprise.

Why First-Class Certification Matters

The old workflow was simple: design the product, build the product, hand it to a lab. That worked when products were simpler, and standards moved slowly. It does not work anymore.

Today, a connected device may carry Wi-Fi 7, Bluetooth LE Audio, a switch-mode power supply, a high-speed processor, and an OTA update path - all within a 30 mm form factor. Each subsystem can breach CISPR 32 emissions levels. Each cable can generate an ESD failure. Each power input can create surge immunity problems. By the time the device reaches the lab, dozens of design decisions that determine its certification have already been made.

The first-pass question reframes from the entire workflow: what would it take for this product to pass its formal EMC, safety, and environmental tests on the first attempt?

The answer is not more rigor at the end. It is diagnostic testing - earlier, cheaper, repeated - at every stage of the product lifecycle. That is a pre-compliance. Done well, it prepares a team for every formal evaluation that follows - emissions, safety, environmental - long before the final chamber booking is made.

The Compliance Lifecycle, Re-engineered

Compliance testing is binary - pass or fail; report goes to a certification body. Pre-compliance is a diagnostic. It shows how close to the boundary a product is, where it is leaking, and what design change will bring it under threshold. A well-architected pre-compliance engagement has 6 distinct stages, each targeting a different failure surface and reducing the risk of failure during final product compliance testing:

Stage 1 - Design Review

Most of the EMC and safety failures have seen downstream trace back to decisions visible at this stage - component placement, ground-plane partitioning, connector position, enclosure material. Reviewing the schematic and layout before the first board is fabricated catches them while a fix still costs a design revision rather than a re-test.

Stage 2 - Emissions Sweep

Characterize radiated and conducted emissions on the first physical prototype, sweeping 9 kHz to 6 GHz against CISPR 32, FCC Part 15, or equivalent regional standard. This EMC testing step is not a verdict, but a spectrum trace with each peak within 10 dB of the limit annotated with probable root cause.

Stage 3 - Immunity Stress Profile

Expose the product to the electromagnetic environment it will operate in - ESD, electrical fast transients, surge, and conducted RF. The output is a ranked list of failure points and the protective components needed to close each one.

Stage 4 - Safety and Thermal Audit

Thermal mapping under worst-case operating conditions, verification of insulation barriers, measurement of creepage and clearance, and evaluation of touch currents at every accessible connection point.

Stage 5 - Environmental & Reliability Snapshot

Assess how the product behaves in its intended surroundings: thermal cycling across the full operating range, vibration, and humidity exposure. For products headed into aerospace, defense or harsh industrial use, add HALT (Highly Accelerated Life Test), which drives temperature and vibration beyond operating limits to expose latent defects before shipping.

Stage 6 - Modular Certification (The Step Most Teams Miss)

If your product uses a previously certified Wi-Fi or Bluetooth module, you may be able to avoid repeating the full radio test campaign. A module may already carry approvals such as an FCC modular grant, Wi-Fi Alliance certification, or Bluetooth SIG Qualification, allowing the host product to inherit or reference that approval where the module is integrated within the grant conditions and regional requirements (Wi-Fi certification; Bluetooth qualification).

One Lab, One Plan, Faster Certification

Fig. 2 One lab, every stamp & Global market access - Tarang Labs covers Wi-Fi, Bluetooth, TEC, EMI/EMC, Calibration, Environmental and Product safety under one roof.

Across all six stages, the deliverable is not a certificate. It is one Integrated Change List (ICL): filter values, ground-plane revisions, cable shielding, firmware mitigations, and mechanical reinforcement - each item tied to a measured margin, so the team knows what to change and how much headroom it buys.

But an ICL assembled from four vendors arrives in fragments - separate queues, separate formats, separate readings of the same failure. Wipro Engineering – Tarang Labs runs Wi-Fi, Bluetooth, TEC, EMI/EMC, calibration, environmental, product safety, and compliance testing services in parallel under one roof, accredited by NABL, A2LA, TEC, FCC, CE, ISED, ILAC and DGAQA - one engagement, prototype to global market access.

Key Considerations

  1. Conduct pre-compliance activities at the design and product freeze levels. It is important to identify pre-compliance issues when design changes can still be made with minimal impact on cost.
  2. Select a pre-compliance lab that can perform all testing required for EMC, safety, environmental, reliability, and product certification readiness under one roof. Testing across domains exposes failure modes a single-discipline lab will miss and running them in parallel - critical for regulated supply chains - protects the launch date.
  3. Demand a diagnostic report, not a verdict. If your lab hands back only a pass or fail, you have bought the wrong service. Insist on margins, root causes, and corrective actions.
  4. Budget compliance margin into your bill of materials. Shielding and protective components cost cents to a few dollars when designed in. Retrofitting them after a failed test costs orders of magnitude more, once new samples, chamber rebooking and a second certification cycle are counted.

"If you're 3 to 6 months from certification, run a pre-compliance diagnostic now - it is the difference between one clean cycle and three painful ones."

Talk to the Wipro Engineering – Tarang Labs chamber team before you freeze your design, not after the lab says no. Contact Us.
